Decision Tree Template: How to Build One With Examples

A decision tree template turns a repeated choice into a visible sequence of questions, branch conditions, and terminal actions. Follow the branch that matches the evidence until the path ends in a named outcome. A useful tree makes policy reviewable; it does not make the decision automatically.

This guide covers operational decision trees—not machine-learning classifiers. It includes a copyable node register and a fictional SaaS release-readiness example with reproducible paths.

Definition: A decision tree is a branching diagram that begins with a question or choice, routes each answer through a labeled branch, and ends each path with an outcome or action.

What is a decision tree template?

A decision tree template is a reusable structure for documenting a rule with a start, internal nodes, labeled connectors, and terminal nodes. It can also keep evidence, ownership, and review details beside the visual.

OpenStax's institutional overview describes a decision tree as a tree-structured decision tool in which branches represent choices and outcomes, and identifies the root, splits, subtrees, and leaf nodes. This article uses that general structure to document a human-reviewed operating policy. It does not cover predictive model training, entropy, pruning, or model accuracy.

A template is valuable when the same bounded choice recurs, such as release readiness, escalation routing, approval gates, or incident triage. It is less useful for open exploration, multi-criteria comparison, or detailed process sequencing.

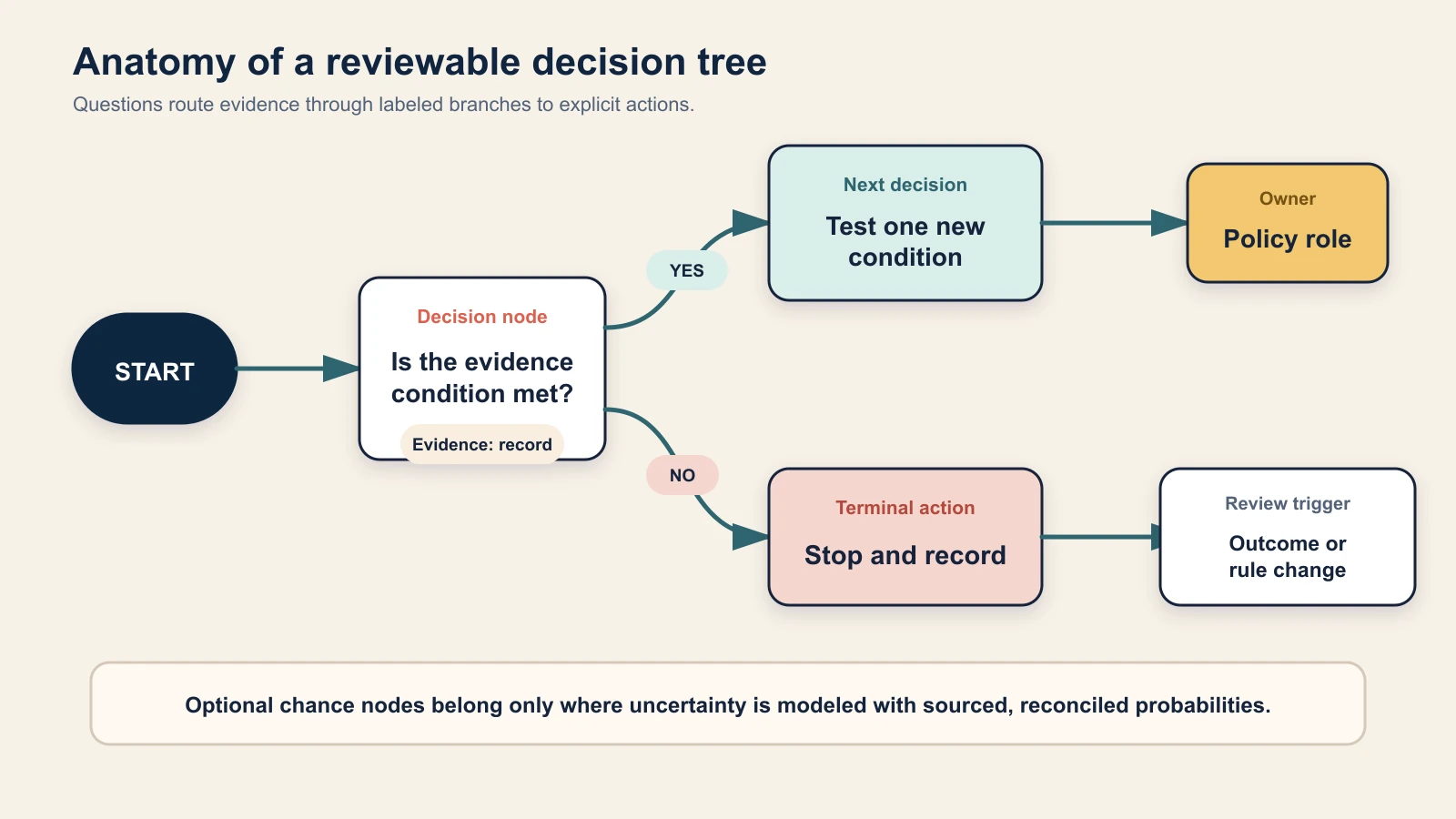

Anatomy of a decision tree with a start node, labeled branches, evidence notes, ownership, and terminal actions.

A reviewable decision tree connects one testable question at a time to labeled branches and explicit terminal actions.

Decision tree anatomy

Use only the elements your decision requires, but define each one consistently:

ElementJob in the treeQuality check
Decision scopeNames the choice, population, trigger, and policy ownerA reader knows when the tree applies and when it does not
Root or start nodeBegins the path with the first question or choiceThere is one unambiguous entry point
Decision nodeTests one observable conditionThe wording can be answered from named evidence
BranchConnects a node to the next node or actionEvery outgoing connector has a distinct label
Chance nodeOptionally represents an uncertain event with probabilitiesProbabilities have a source, date, and reconciled total
Terminal nodeEnds a path with an outcome or actionNo path stops at an unanswered question
Evidence noteIdentifies the record used to answer a nodeThe source and acceptable age are clear
OwnerNames the accountable role for the policy or actionOwnership is a role, not an anonymous “team”
Review conditionStates when the rule must be revisitedOutcomes, policy changes, and failed assumptions can trigger review

The familiar diamond is useful but not mandatory. A card or text outline can work if questions, branches, and endpoints remain unmistakable. Microsoft's current Visio guidance treats drawing a decision tree as a flowcharting task; the author still owns the logic.

Copyable decision tree planning table

Draft the logic in a table before polishing the diagram. The table exposes missing branches and makes review possible without interpreting a canvas.

Node IDQuestion or conditionBranch labelNext nodeTerminal actionEvidence requiredOwnerReview condition
D1Write one testable questionYesD2 or —Action if this path endsRecord, test, or policyAccountable roleOutcome, date, or rule change
D1Repeat the same questionNoD3 or —Action if this path endsSame evidence boundaryAccountable roleOutcome, date, or rule change

Create one row for every outgoing branch. If an answer can be unknown, add an explicit Unknown branch or define how missing evidence is resolved. Do not silently treat unknown as no.

When should you use a decision tree?

Use a decision tree when:

  • The decision is bounded and repeatable.
  • Conditions are observable and understandable.
  • The next question depends on an earlier answer.
  • Each path can end in a named action.
  • Someone owns the rule and reviews outcomes.

Choose another method when those conditions do not hold. For open exploration, start with online whiteboard templates for brainstorming. For comparing several viable options across weighted criteria, use a decision matrix template. For showing a process from start to finish, use a flowchart guide or a swimlane diagram when handoffs and roles are central.

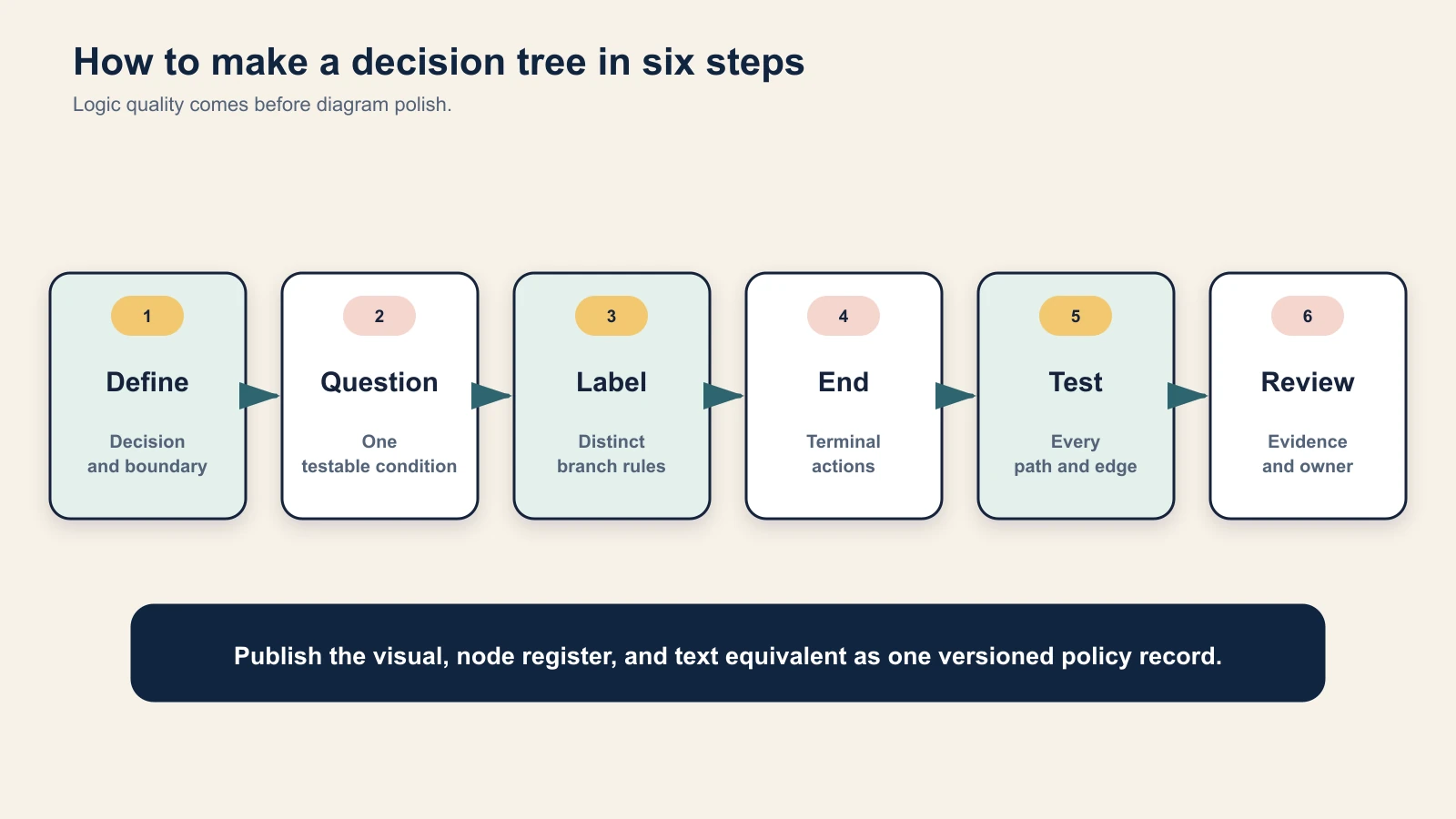

How to make a decision tree in six steps

The following workflow is a recommended implementation practice. It is not a universal standard, and teams should adapt review rigor to the consequence of the decision.

1. Define one decision and its boundary

Write the trigger, population, accountable owner, and desired terminal actions. “Should we release this change under the current readiness policy?” is bounded. “What should the company do?” is not.

List conditions that require specialist judgment, legal advice, safety escalation, or emergency authority outside the tree.

2. Write one testable question per decision node

Use a condition that can be answered from evidence. “Does the release feel safe?” is subjective. “Is any critical defect unresolved under the current defect policy?” points reviewers to a named classification and record.

Avoid compound questions such as “Are tests passing and rollback ready?” A no answer hides which condition failed.

3. Label every outgoing branch

Yes and No suit binary conditions, but branches can use distinct categories or ranges. Make labels mutually exclusive where practical. If two branches can apply, define precedence or redesign the node.

4. End every path with a terminal action

A branch must lead to another decision or a named endpoint. “Review” is incomplete unless it says who reviews what and what happens next.

5. Walk-test paths and edge cases

Read each path using concrete evidence. Check unreachable nodes, missing connectors, loops, contradictory labels, and implicit defaults. Ask a new reviewer to follow a normal path, a stop path, and a missing-evidence path.

6. Add evidence, ownership, and review triggers

Record the evidence source and policy owner. Compare the prescribed route with real outcomes, and revise rules only through documented, versioned changes.

Workflow from a bounded decision through branch rules, terminal actions, path testing, and outcome review.

Define the boundary before drawing, then test every path and review the policy against real outcomes.

Worked decision tree example: fictional release readiness

This SaaS release-readiness tree is fictional teaching material—not AFFiNE policy, customer data, safety guidance, or a substitute for engineering, security, compliance, or incident procedures. It uses four decision nodes, five terminal actions, and no probabilities or costs.

Policy assumptions

  • “Critical defect” is defined by the fictional team's existing severity policy.
  • The release owner can inspect the unresolved-defect register and rollback test record.
  • A migration means a change to persisted data or infrastructure that requires a staged validation path.
  • Pilot exit criteria are written before the pilot and include technical and operational evidence.
  • Unknown or missing evidence does not pass a gate; the owner stops at the relevant delay or remediation action.

Node register

NodeQuestionYes routeNo routeEvidenceOwner
D1Is any critical defect unresolved?T1: stop and remediateD2Defect register under current severity policyRelease owner
D2Has the rollback path been tested for this release?D3T2: delay release and test rollbackDated rollback test recordRelease owner
D3Is a migration required?T4: begin a controlled standard releaseD4: begin a pilot releaseChange record and migration planTechnical lead
D4Does the pilot meet the predefined exit criteria?T5: expand graduallyT3: roll back and investigatePilot evidence against the frozen criteriaPilot owner

Validation method for this teaching example: We enumerated all five root-to-terminal paths, checked each transition against the node register, and confirmed that every route ends in one of five explicit actions. This checks internal routing completeness only; it does not validate a real release policy or predict production outcomes.

At D3, No migration required routes to the controlled standard release, while Migration required routes to the pilot. Branch labels—not position or color—determine meaning.

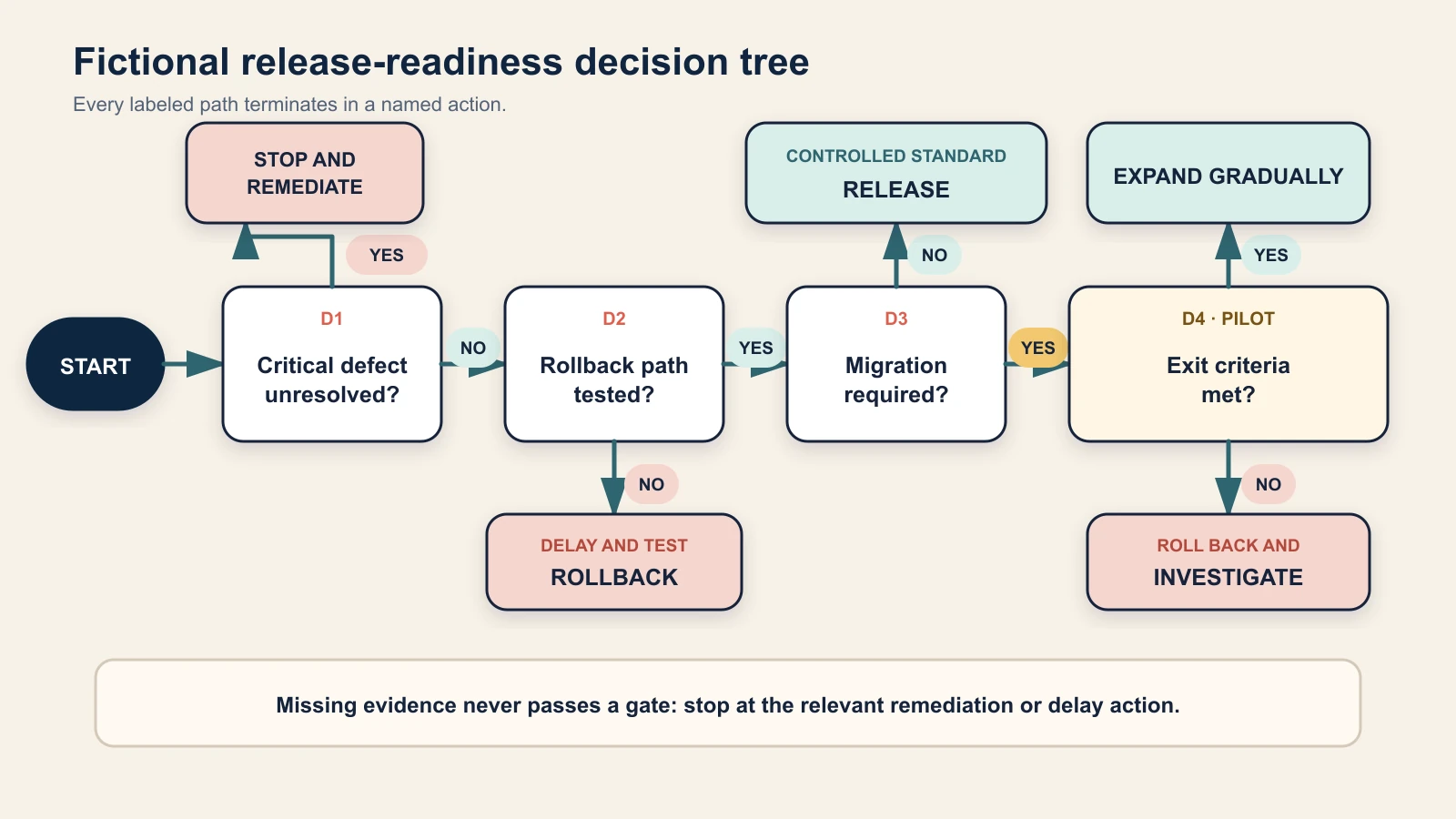

Validated fictional release-readiness decision tree with four questions and five terminal actions.

The fictional example stops for a critical defect or untested rollback, otherwise selecting a standard release or migration pilot with a defined exit check.

Text equivalent: every complete path

  1. If a critical unresolved defect exists, stop and remediate.
  2. If no critical defect exists but the rollback path is not tested, delay the release and test rollback.
  3. If no critical defect exists, rollback is tested, and no migration is required, begin a controlled standard release.
  4. If no critical defect exists, rollback is tested, a migration is required, and the pilot meets its predefined exit criteria, expand gradually.
  5. If no critical defect exists, rollback is tested, a migration is required, and the pilot does not meet its predefined exit criteria, roll back and investigate.

All five paths terminate without an undefined “continue.” A real policy would also define authorization, monitoring, rollback triggers, evidence retention, and emergency exceptions.

What the example does—and does not—decide

The tree makes a stated policy reviewable. It does not prove that the severity definition is sound, a rollback test predicts production behavior, or a pilot is risk-free. Record any owner override and rationale.

If the team discovers a gap between current evidence and a required gate, a gap analysis template can structure the current state, target state, causes, and actions. That is a different job from routing the immediate release decision.

Are probabilities required in a decision tree?

No. A rule-based decision tree can route observable conditions without probabilities. Chance nodes and expected values are optional additions for decisions under uncertainty, not defining features of every tree.

If you add probabilities, publish their source, period, sample boundary, and uncertainty. Sibling probabilities at one chance node should reconcile to 100%, allowing explained rounding. Use comparable value units and disclose assumptions.

Expected value can summarize probability-weighted outcomes, but it cannot capture every concern, including risk tolerance, irreversibility, legal duties, or unreliable inputs. Weak probability evidence is a reason to keep the tree rule-based.

Decision tree vs. matrix, flowchart, fault tree, and checklist

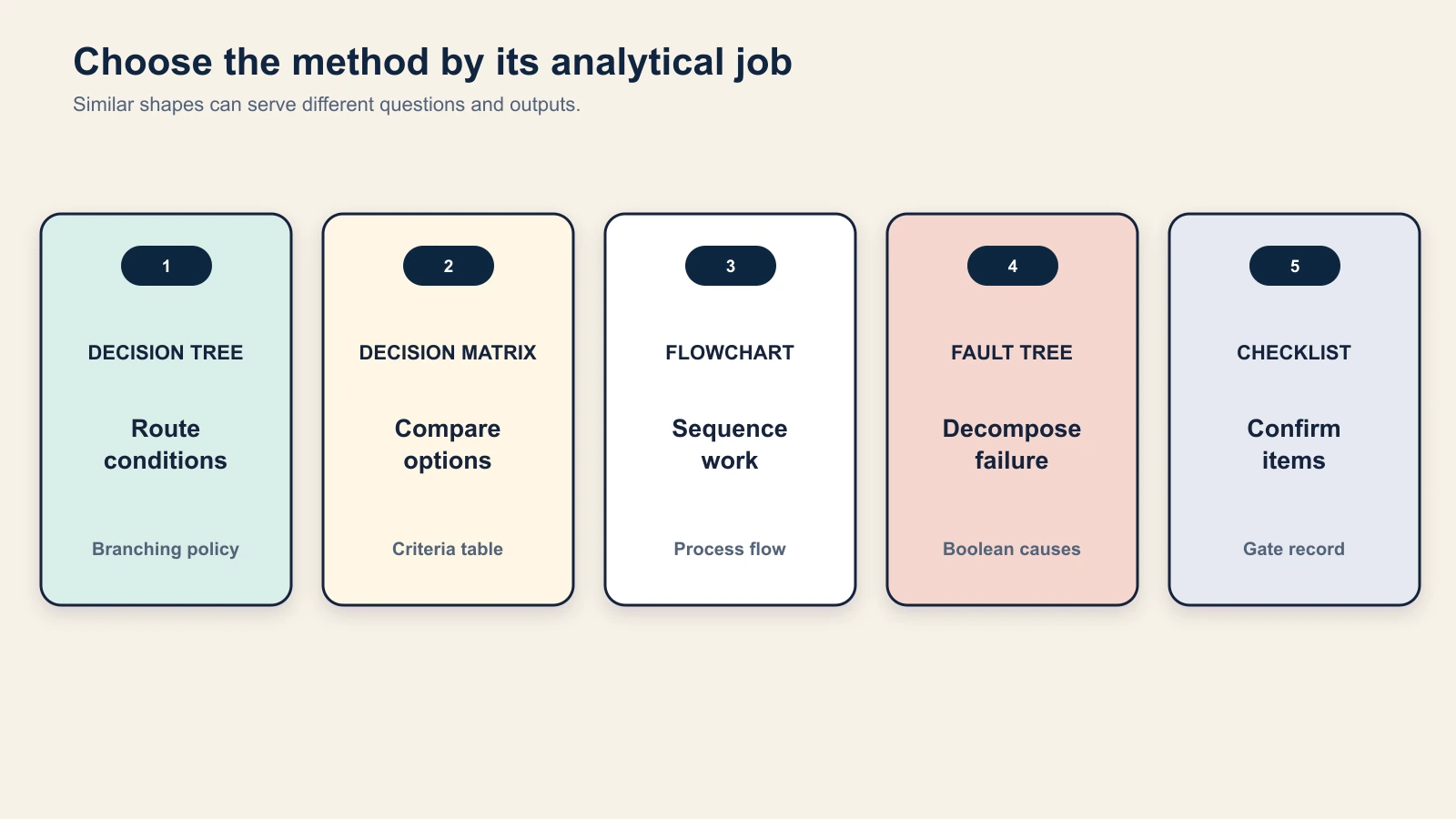

Comparison of decision trees, decision matrices, flowcharts, fault trees, and yes-no checklists by purpose and output.

MethodPrimary questionStructureBest output
Decision treeWhat action follows from this sequence of conditions?Branching paths with terminal outcomesReviewable decision policy or scenario routing
Decision matrixWhich viable option performs best against defined criteria?Options-by-criteria table, optionally weightedTransparent comparison with sensitivity checks
FlowchartWhat steps and decisions occur in a process?Sequential activities and decision pointsProcess logic from start to finish
Fault treeHow can a defined undesired event occur?Top-down logical decomposition of failure eventsFailure pathways for risk analysis
Yes/no checklistHave required items been confirmed?Independent or ordered checksCompletion record or gate evidence

The distinction from a fault tree is especially important. NIST defines fault tree analysis as a top-down, deductive analysis of an undesired system state using Boolean logic to combine lower-level events. A decision tree routes choices or conditions toward actions and outcomes; a fault tree decomposes how a failure can occur. Similar branching shapes do not make the methods interchangeable.

A flowchart can contain decision diamonds, and a decision tree can be drawn with flowchart shapes. Choose the name from the analytical job, not the drawing library.

Make the decision tree accessible

A visual tree needs a text equivalent that preserves meaningful order. Publish the node register or complete paths next to the image, with readable type, adequate contrast, and clear connectors.

Do not use color as the only branch cue. The W3C guidance for use of color recommends adding shape or text when color conveys meaning. Label connectors directly with Yes, No, a category, or a range. The text equivalent should state the same routing in a linear order, supporting the W3C meaningful-sequence guidance.

For complex trees, use named subtrees and stable node IDs. Never distinguish branches solely by left-versus-right position.

Common decision tree mistakes

  1. Compound questions hide the failed condition. Use one testable condition per node.
  2. Branches overlap. Define distinct ranges, categories, or precedence rules.
  3. A path has no terminal action. End every connector at another node or explicit outcome.
  4. Unknown evidence silently becomes No. Add an Unknown path or a safe evidence-resolution rule.
  5. Connectors depend on color or position. Label them in text and publish a linear equivalent.
  6. The tree loops forever. Operational decision policies should reach a terminal action; handle later reviews as a new decision event.
  7. Probabilities do not reconcile. Check siblings at each chance node and document rounding.
  8. Assumptions are invisible. Put definitions, sources, and evidence age beside the node register.
  9. The tree becomes an automatic authority. Keep an accountable human owner and exception process.
  10. Old policy remains in circulation. Add a version, review date, change record, and archive rule.

Keep the tree and evidence together in AFFiNE

AFFiNE's current whiteboard and document surfaces can support a practical workflow: sketch nodes and connectors, keep the node register and text equivalent in a document, and store evidence notes, owners, and review decisions together. It is a collaborative record, not a decision engine; AFFiNE does not validate the policy, estimate probabilities, or authorize outcomes.

Start-now checklist

  1. Name one recurring decision and accountable policy owner.
  2. Define the trigger, scope, exceptions, and terminal actions.
  3. Draft one evidence-answerable question per node.
  4. Label every branch and handle missing evidence explicitly.
  5. Walk every path to a terminal action.
  6. Publish a node register and text equivalent.
  7. Review real outcomes and version any rule change.

Frequently asked questions

What is a decision tree template?

A decision tree template is a reusable structure for documenting a choice as a sequence of questions, labeled branches, and terminal outcomes. Teams fill it with their own evidence rules, actions, owners, and review triggers.

How do you create a decision tree?

Define one bounded decision, write one testable question per node, label every outgoing branch, end each path with an action, walk-test normal and edge cases, then add evidence sources, ownership, and a review trigger.

What is the difference between a decision tree and a flowchart?

A decision tree emphasizes how conditions or choices branch toward outcomes. A flowchart emphasizes the sequence of activities in a process, although it may include decision points. The same shapes can appear in both; the job and structure determine the name.

Do decision tree branches have to be yes or no?

No. Yes and No work for binary conditions, but branches can use mutually exclusive categories or ranges. Every label should be distinct, evidence-based, and complete enough to route the states the policy expects.

What symbols are used in a decision tree?

Common diagrams use a start or root, decision nodes, connectors, optional chance nodes, and terminal or leaf nodes. Consistent labels and complete routing matter more than using one mandatory shape set.

Does every decision tree need probabilities?

No. Rule-based trees often use observable conditions without probabilities. Add chance nodes only when uncertainty is central and the probabilities have defensible, documented sources.

Can a decision tree choose the best option automatically?

Not by itself. It applies the rules and inputs its authors provide. It cannot discover missing options, repair poor evidence, resolve ethical or legal duties, or replace an accountable decision owner.

Conclusion

A strong decision tree template is a compact policy record: one bounded decision, testable nodes, labeled branches, explicit terminal actions, evidence, ownership, and a review trigger. The fictional release example shows five complete paths without pretending that a diagram removes uncertainty. Build the tree in a table first, verify every route, publish a text equivalent, and treat the visual as decision support—not authority.
